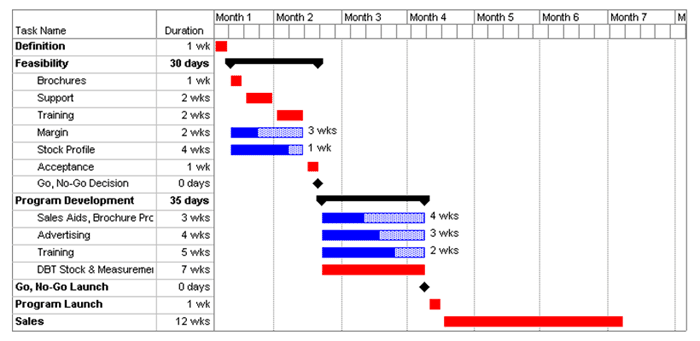

Gantt
                  Chart for the New Product Launch Project – with Critical
                  Path and Slack:
                    This Gantt Chart provides even more detail. The tasks shown
                    in red must be performed exactly as scheduled or the overall
                    project schedule will be changed. These tasks are on the
                    critical path, and we will learn more about it later in this
                    lesson. The tasks shown in blue can be performed earlier
                    or later without affecting the project schedule. In other
                    words, there is slack or extra time in the schedule for those
                    tasks, as shown by the light blue area. The weeks of slack
                    time for each task off the critical path is indicated to
                    the right of the bar.

  |
