Organizational
                  Requirements – monitor trends (continued)

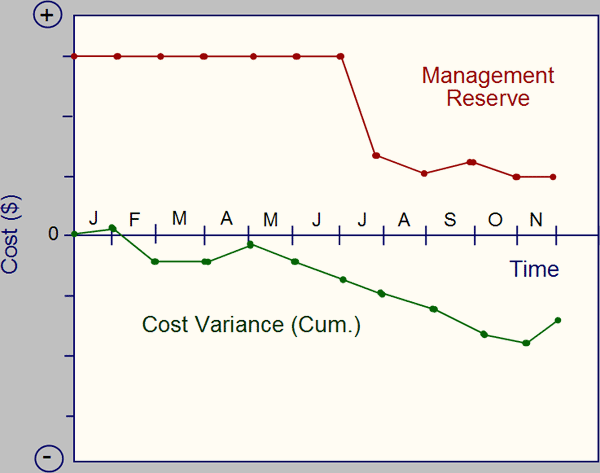

                  In this trend example, cost variance goes negative early in
                  the project, meaning that cost overrun is occurring. Until
                  end of June the team is able to absorb the monthly over expenditures.
                  Then, they must dip into management reserves (risk contingency)
                  to finance the unanticipated costs. This seems to correct the
                  problem, as CV is becoming positive, and reserve money remains.

  |
