Remember our
                New Product Launch Example?
               |
              Are
                    the resources scheduled
                    smoothly? (continued)

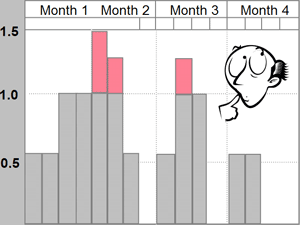

        Here is the New Product Launch project again showing both over and under
        allocation of the Project Manager in the resource histogram. Remember
        that the PM assigned himself to too many tasks in the Project Organization
        stage of planning. This is the result, and it is seen very late in the
        planning cycle.
                In this real example, the PM quickly realized
                  both the problem and the solution. He and the team recycled
                  back to the WBS and Project Organization. They rescheduled
                  the PM’s time to work only one-half time on the project,
                  but consistently from start to finish. Other team members volunteered
                  to do the tasks originally allocated to the PM. When re-structured
                  in this manner, the project was accomplished very successfully.
                  Without the re-structuring, the project may have failed.  |
