Risk
                    Analysis – an
                  example from Airbus

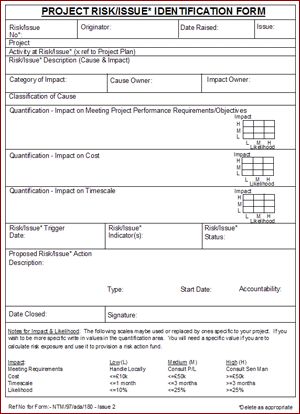

                  Airbus UK uses a very complete one-page form for risk analysis.
                  They identify the risk owner and others who may be impacted
                  by the risk. The trigger date is a data field stored in a data
                  base. Reports are requested frequently showing identified risks
                  that were to trigger at the time of the next team meeting.

                For each task, a risk matrix is used to assess
                  the following risks:

                  - Impact on meeting requirements/objectives



                  - Impact on cost



                  - Impact on schedule

                                   For consistency, a legend
                    is given at the bottom of the form to standardize the assessments
                    regarding Impact and
                        Likelihood of Occurrence for each factor of the triple
                        constraint:
                          meeting planned results/requirements, cost, and schedule.   |
